Task Scheduling Algorithms

Info

This document is a work in progress and will be updated regularly.

Introduction

Scheduling a task graph on networked computers is a fundamental problem in distributed computing. Essentially, the goal is to assign computational tasks to different compute nodes in such a way that minimizes/maximizes some performance metric (e.g., total execution time, energy consumption, throughput, etc.).

We will focus on the task scheduling problem concerning heterogeneous task graphs and compute networks with the objective of minimizing makespan (total execution time) under the related machines model1.

It is common to model distributed applications as task graphs, where nodes represent computational tasks and directed edges represent precedence constraints and the flow of input/output data. As a result, task scheduling pops up all over the place - from machine learning and scientific workflows, to IoT/edge computing applications, to data processing pipelines used all over industry.

Figure 1 depicts a scientific workflow application used by Caltech astronomers to generate science-grade mosaics from astronomical imagery[montage].

Montage Image Figure 1a: Montage astronomical image

Montage Workflow Figure 1b: Montage scientific workflow structure

Problem Definition

Let us denote the task graph as G=(T,D)G = (T,D), where TT is the set of tasks and DD contains the directed edges or dependencies between these tasks. An edge (t,t′)∈D(t,t') \in D implies that the output from task tt is required input for task t′t'. Thus, task t′t' cannot start executing until it has received the output of task tt. This is often referred to as a precedence constraint.

For a given task t∈Tt \in T, its compute cost is represented by c(t)∈R+c(t) \in \mathbb{R}^+ and the size of the data exchanged between two dependent tasks, (t,t′)∈D(t, t') \in D, is c(t,t′)∈R+c(t, t') \in \mathbb{R}^+.

Let N=(V,E)N = (V, E) denote the compute node network, where NN is a complete undirected graph. VV is the set of nodes and EE is the set of edges. The compute speed of a node v∈Vv \in V is s(v)∈R+s(v) \in \mathbb{R}^+ and the communication strength between nodes (v,v′)∈E(v, v') \in E is s(v,v′)∈R+s(v,v') \in \mathbb{R}^+.

Under the related machines model[graham], the execution time of a task t∈Tt \in T on a node v∈Vv \in V is c(t)s(v)\frac{c(t)}{s(v)}, and the data communication time between tasks (t,t′)∈D(t, t') \in D from node vv to node v′v' (i.e., tt executes on vv and t′t' executes on v′v') is c(t,t′)s(v,v′)\frac{c(t, t')}{s(v, v')}.

The goal is to schedule the tasks on different compute nodes in such a way that minimizes the makespan (total execution time) of the task graph.

Let A\mathcal{A} denote a task scheduling algorithm. Given a problem instance (N,G)(N, G) which represents a network/task graph pair, let SA,N,GS_{\mathcal{A},N,G} denote the schedule produced by A\mathcal{A} for (N,G)(N, G). A schedule is a mapping from each task to a triple (v,r,e)(v, r, e) where vv is the node on which the task is scheduled, rr is the start time, and ee is the end time.

A valid schedule must satisfy the following properties:

  • All tasks must be scheduled: for all t∈Tt \in T, SA,N,G(t)=(v,r,e)S_{\mathcal{A},N,G}(t) = (v, r, e) must exist such that v∈Vv \in V and 0≤r≤e0 \leq r \leq e.

  • All tasks must have valid start and end times: ∀t∈T,SA,N,G(t)=(v,r,e)  ⟹  e−r=c(t)s(v)\forall t \in T, S_{\mathcal{A},N,G}(t) = (v, r, e) \implies e - r = \frac{c(t)}{s(v)}

  • Only one task can be scheduled on a node at a time (i.e., their start/end times cannot overlap): ∀t,t′∈T,t≠t′,SA,N,G(t)=(v,r,e)∧SA,N,G(t′)=(v,r′,e′)  ⟹  e≤r′∨e′≤r\forall t, t' \in T, t \neq t', S_{\mathcal{A},N,G}(t) = (v, r, e) \land S_{\mathcal{A},N,G}(t') = (v, r', e') \implies e \leq r' \lor e' \leq r

  • A task cannot start executing until all of its dependencies have finished executing and their outputs have been received at the node on which the task is scheduled: ∀(t,t′)∈D,SA,N,G(t)=(v,r,e)∧SA,N,G(t′)=(v′,r′,e′)  ⟹  e+c(t,t′)s(v,v′)≤r′\forall (t, t') \in D, S_{\mathcal{A},N,G}(t) = (v, r, e) \land S_{\mathcal{A},N,G}(t') = (v', r', e') \implies e + \frac{c(t, t')}{s(v, v')} \leq r'

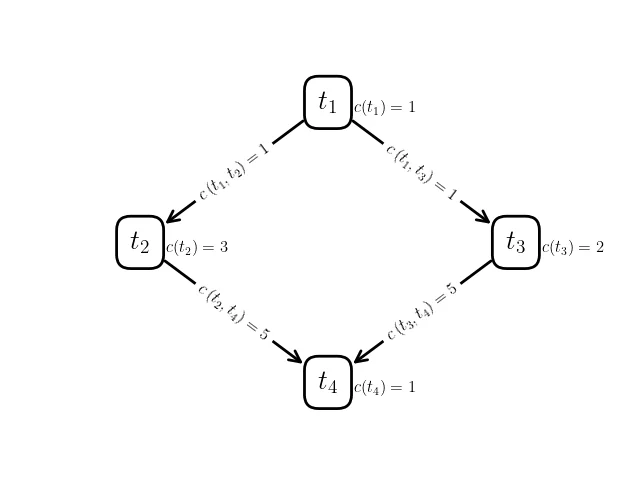

Task Graph Figure 2a: Example task graph

Network Figure 2b: Example compute network

Schedule Figure 2c: Example schedule (Gantt chart)

We define the makespan of the schedule SA,N,GS_{\mathcal{A},N,G} as the time at which the last task finishes executing: MA(N,G)=max⁡t∈T∣SA,N,G(t)=(v,r,e)eM_{\mathcal{A}(N,G)} = \max_{t \in T \mid S_{\mathcal{A},N,G}(t) = (v, r, e)} e

Example 1

Take a look at the task graph, network, and schedule in Figure 2. Let us start by verifying that this is a valid schedule for the problem instance (network/task graph pair).

First, task t1t_1 is scheduled to run on node v1v_1. Clearly this is valid, since t1t_1 has no dependencies. When t1t_1 finishes running at time 11, which is valid since the cost of task t1t_1 is 11 and the speed of node v1v_1 is 11 (1/1=11/1=1).

Then, t2t_2 immediately starts running at time 11 on node v1v_1. Again, this is clearly valid since there is no communication delay in sending the outputs from task t1t_1 to another node before running task t2t_2.

Task t3t_3, on the other hand, is scheduled to run on node v2v_2. In this case, 11 unit of output data from task t1t_1 must be sent to node v2v_2 as input data to task t3t_3. The communication link between nodes v1v_1 and v2v_2 is 22, so this communication takes 1/21/2 units of time. Thus, the start time of task t3t_3 is valid since it is exactly 1/21/2 units of time after task t1t_1 terminates.

It's easy to verify that tasks t3t_3 and t2t_2 have valid runtimes according to their costs and the speeds of the nodes they're running on.

Finally, task t4t_4 is scheduled to run on node v2v_2. Before it can start running, though, the 55 units of output data from task t2t_2 must be sent from node v1v_1 to node v2v_2 over a communication link of strength 22. Thus, the start time of task t4t_4 is correct (5/2=2.55/2=2.5 units of time after task t2t_2's finish time).

Thus, the schedule in Figure 2c is valid and has a makespan of 77.

The HEFT Scheduling Algorithm

This task scheduling problem has long been known to be NP-Hard and was recently shown to also be not polynomial-time approximable within a constant factor[inapproximable]. As a result, many heuristic algorithms that aren't guaranteed to produce an optimal schedule but that, in practice, have been shown to work reasonably well have been proposed over the past decades.

One of the most commonly used of these algorithms is HEFT (Heterogeneous Earliest Finish Time)[heft]. HEFT is a list-scheduling algorithm, which essentially means it first computes priorities for each of the tasks in the task graph and then schedules the tasks greedily in order of their priority on the "best" node (the one that minimizes the task's finish time, given previously scheduled tasks).

Here is a summary of the algorithm:

  1. Calculate average compute times for each task: comp‾(t)=1∣V∣∑v∈Vc(t)s(v)∀t∈T\overline{\text{comp}}(t) = \frac{1}{|V|} \sum_{v \in V} \frac{c(t)}{s(v)} \quad \forall t \in T

  2. Calculate average communication times for each dependency: comm‾(t1,t2)=1∣E∣∑(v1,v2)∈E,v1≠v2c(t1,t2)s(v1,v2)∀(t1,t2)∈D\overline{\text{comm}}(t_1,t_2) = \frac{1}{|E|} \sum_{(v_1,v_2) \in E, v_1 \neq v_2} \frac{c(t_1,t_2)}{s(v_1,v_2)} \quad \forall (t_1,t_2) \in D

  3. Calculate the upward rank of each task (recursively): urank(t)=comp‾(t)+max⁡t′∈T∣(t,t′)∈D{comm‾(t,t′)+urank(t′)}∀t∈T\text{urank}(t) = \overline{\text{comp}}(t) + \max_{t' \in T | (t,t') \in D} \left\{ \overline{\text{comm}}(t,t') + \text{urank}(t') \right\} \quad \forall t \in T

  4. In descending order of task upward ranks, greedily schedule each task on the node that minimizes its earliest possible finish time given previously scheduled tasks.

HEFT Example Calculations

Taskcomp‾(t)\overline{\text{comp}}(t)
t1t_12/3
t2t_22
t3t_34/3
t4t_42/3

Table 1: Average compute times for each task

t→t′t \rightarrow t'comm‾(t,t′)\overline{\text{comm}}(t,t')
t1→t2t_1 \rightarrow t_22/3
t1→t3t_1 \rightarrow t_32/3
t2→t4t_2 \rightarrow t_410/3
t3→t4t_3 \rightarrow t_410/3

Table 2: Average communication times for each dependency

Taskurank(t)\text{urank}(t)
t1t_122/3
t2t_26
t3t_316/3
t4t_42/3

Table 3: Upward rank of each task

Figure 3 shows three valid schedules for the same problem instance. Figure 3a shows the first schedule we validated in the previous section with makespan 77. Figure 3b shows the schedule that the HEFT algorithm produces with a slightly better makespan of 66. Finally, Figure 3c shows the best schedule for this problem instance, which has a makespan of just 3.53.5. This is almost half the makespan of the schedule that HEFT (one of the most widely used scheduling algorithms) produces!

First Schedule Figure 3a: Initial schedule (makespan = 7)

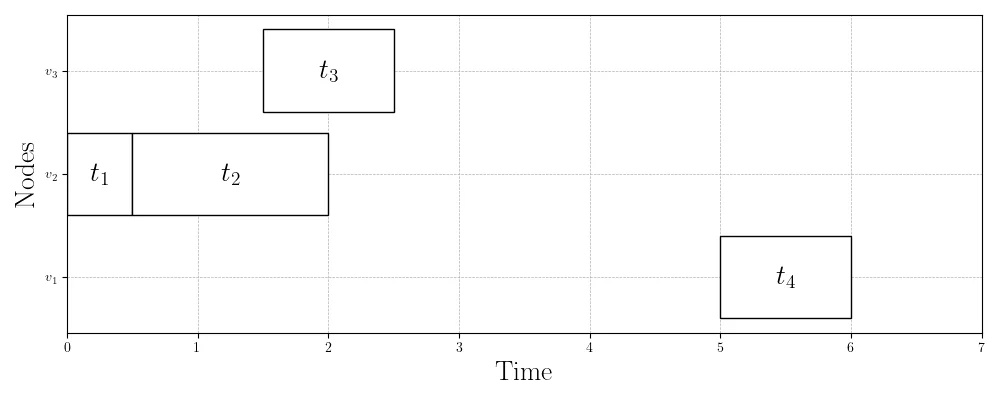

HEFT Schedule Figure 3b: HEFT schedule (makespan = 6)

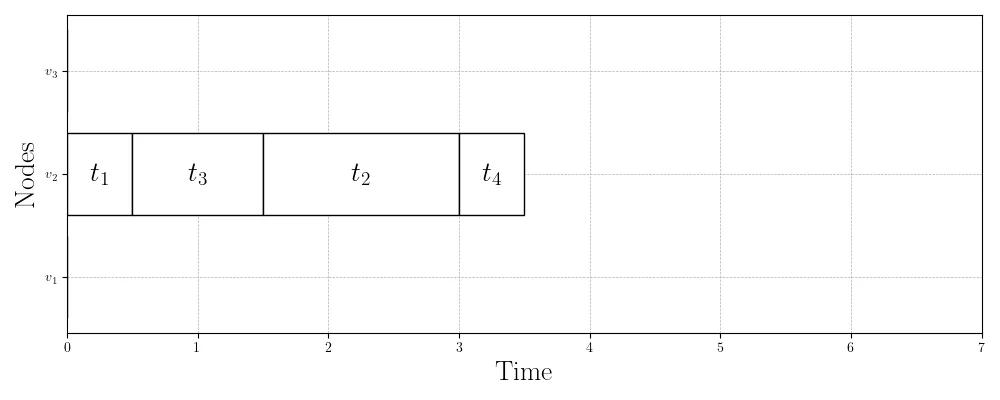

Optimal Schedule Figure 3c: Optimal schedule (makespan = 3.5)

Questions to Consider

  1. Upward rank has the important property that a task's upward rank is always greater than the upward rank of its dependent tasks. Why is this important?
  2. What is the runtime of HEFT in terms of ∣T∣|T|, ∣D∣|D|, ∣V∣|V|, and ∣E∣|E|?
  3. Why does HEFT perform poorly on the problem instance in Figure 2? Can you think of an algorithm that would do better?

My Research Interests

Task scheduling is a fundamental problem in computer science that pops up everywhere. In this lecture, we formalized the task scheduling problem for heterogeneous task graphs and compute networks with the objective of minimizing makespan (total execution time) under the related machines model. Many other interesting variants of the task scheduling problem exist (see[graham-survey]).

We also learned HEFT, one of the most popular task scheduling heuristic algorithms, and saw a problem instance on which it performs rather poorly. Hundreds of heuristic algorithms have been proposed in the literature over the past decades ([eleven] has nice descriptions of eleven scheduling algorithms). Due to their reliance on heuristics (since the problem is NP-Hard), all of these algorithms have problem instances on which they perform very poorly.

The performance boundaries between heuristic algorithms are not well-understood, however. This is an area of my research. We look at methodologies for comparing task scheduling algorithms to better understand the conditions under which they perform well and poorly.

Figures 4 and 5 depict results from our efforts in this area. Figure 4 shows benchmarking results for 15 scheduling algorithms on 16 datasets. The color represents the maximum makespan ratio (MMR) of an algorithm on a problem instance in a given dataset. The MMR of an algorithm is essentially how many times worse the algorithm performs on a particular problem instance compared to the other scheduling algorithms. For example, on some problem instances in the cycles dataset, the BIL algorithm performs more than five times worse than another one of the 15 algorithms! On other problem instances in the same dataset, however, the algorithm performs well (MMR=1).

Figure 5 shows results from our own comparison method that pits algorithms against each other and tries to find a problem instance where one algorithm maximally underperforms compared to another. Our hope is that by identifying these kinds of problem instances, we can better understand the conditions under which algorithms perform well/poorly.

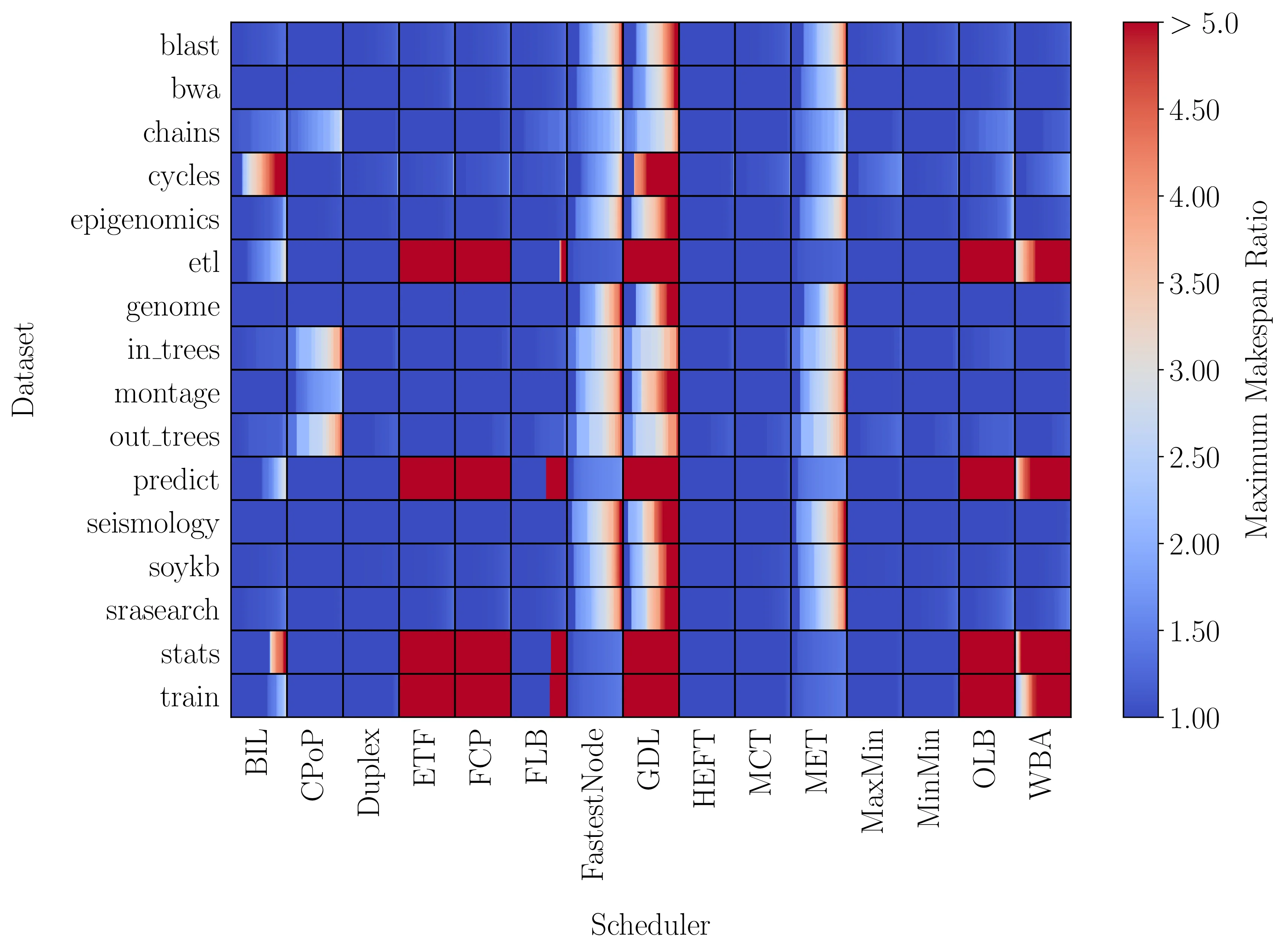

Benchmarking Results Figure 4: Benchmarking results for 15 scheduling algorithms on 16 datasets

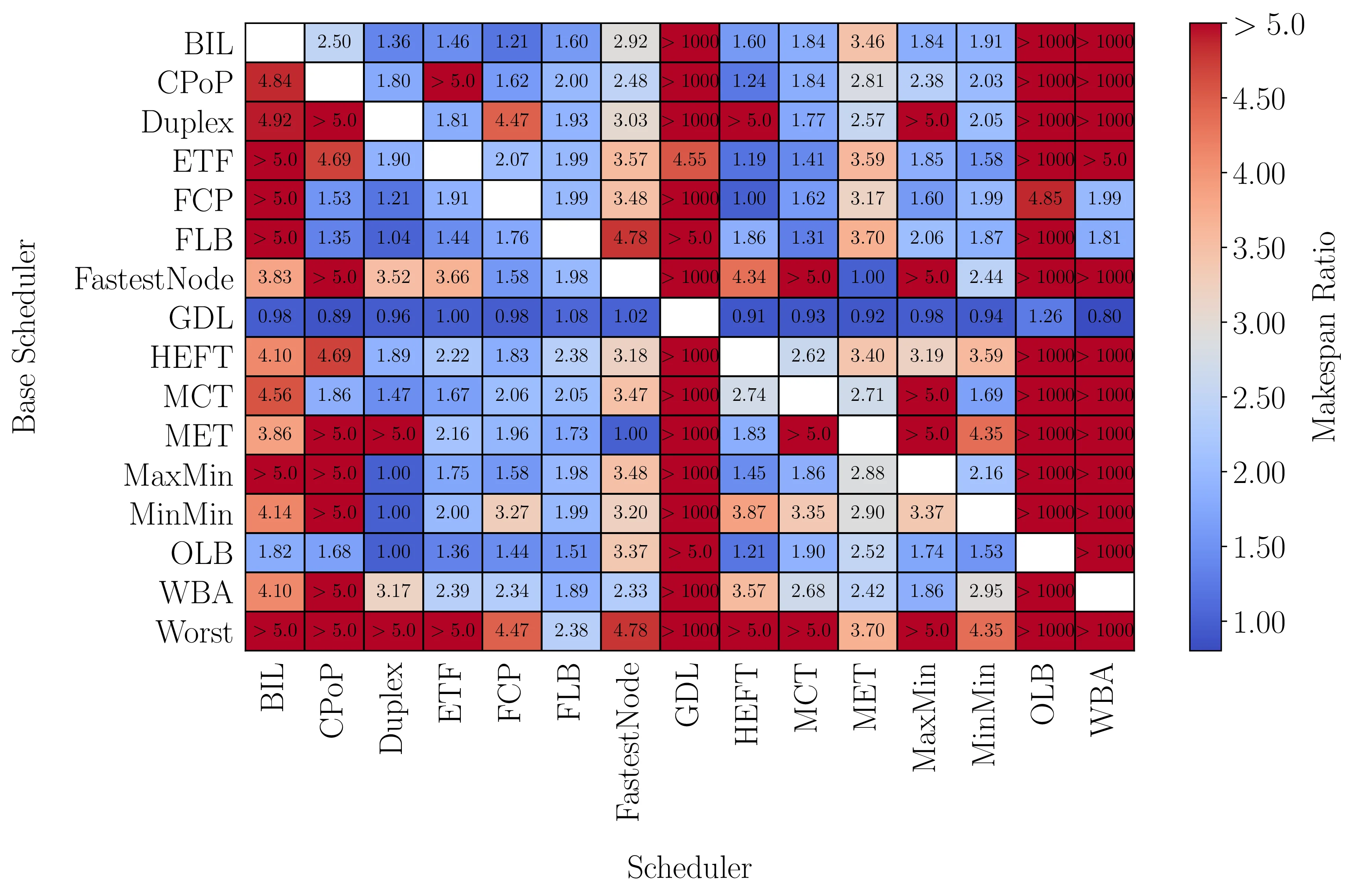

Adversarial Analysis Figure 5: Adversarial analysis results for 15 scheduling algorithms
